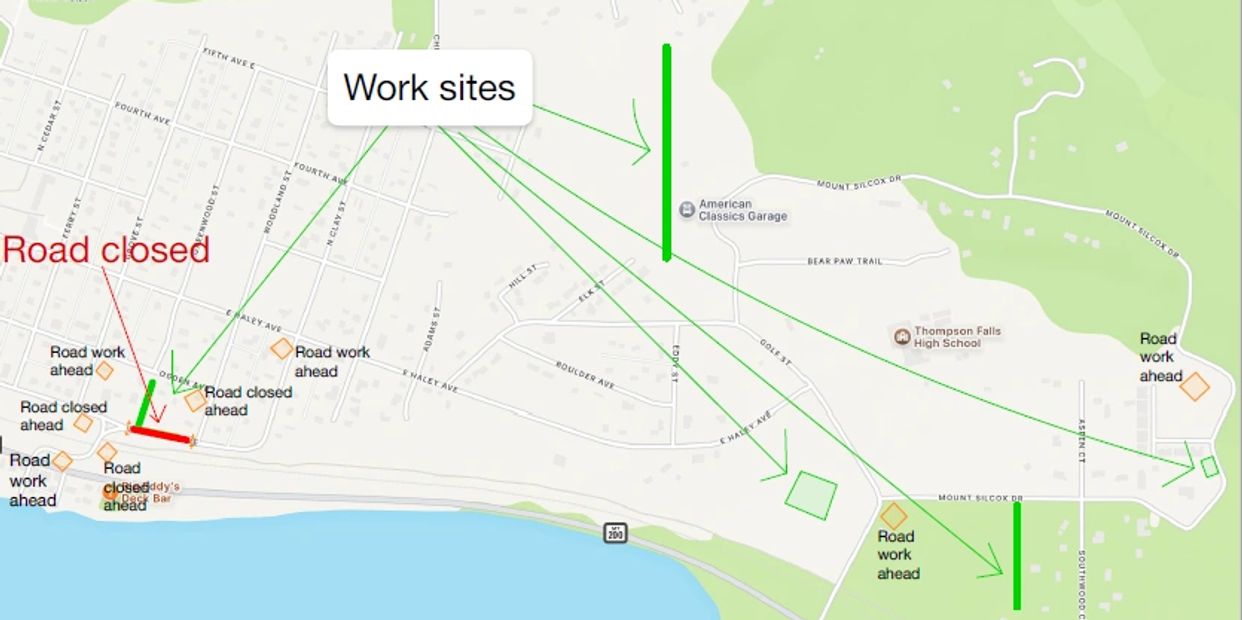

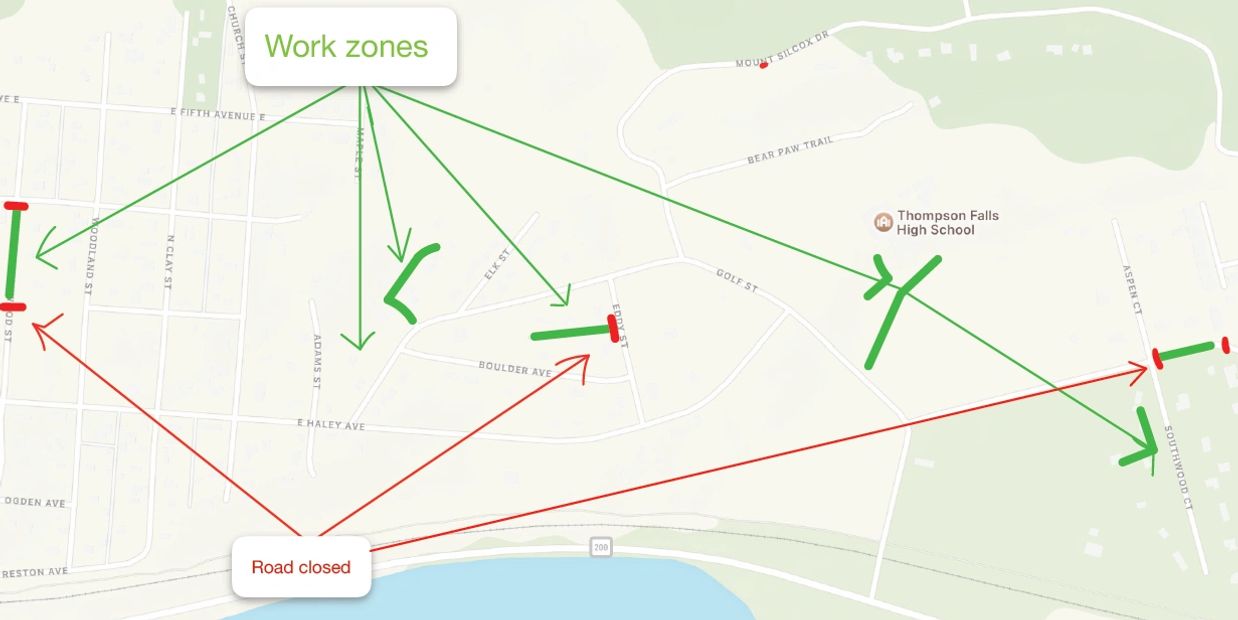

Construction update starting 10/22/26:

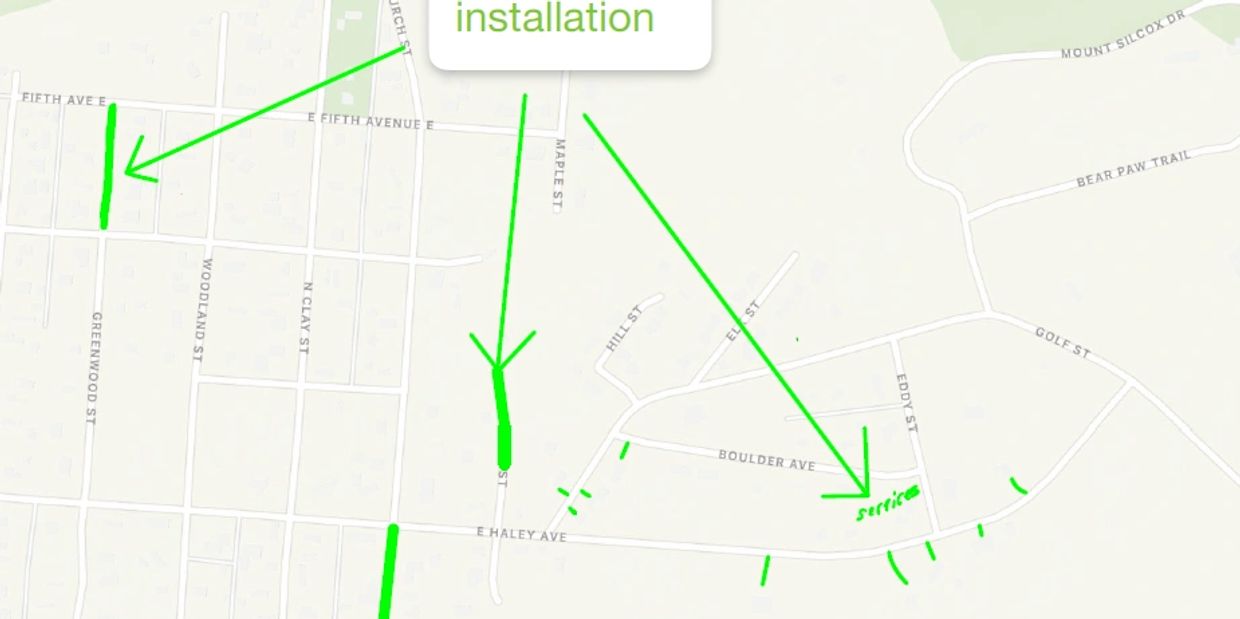

· The crew on 5th and Maple will continue installing pumps, then they will start on pressure lines.

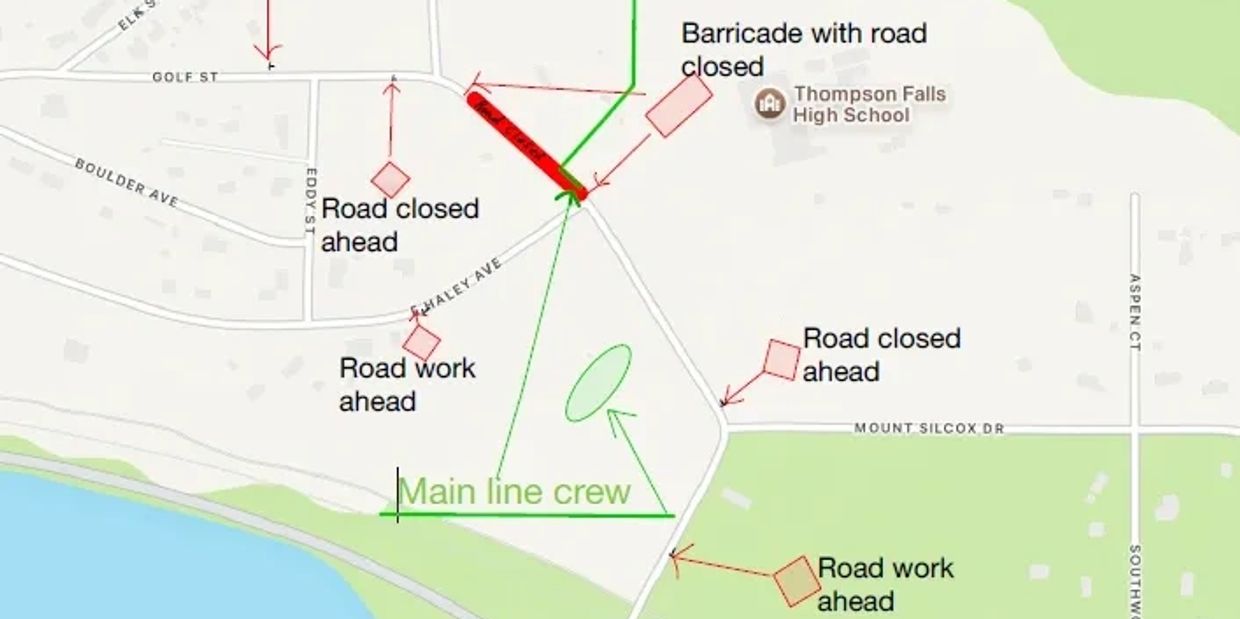

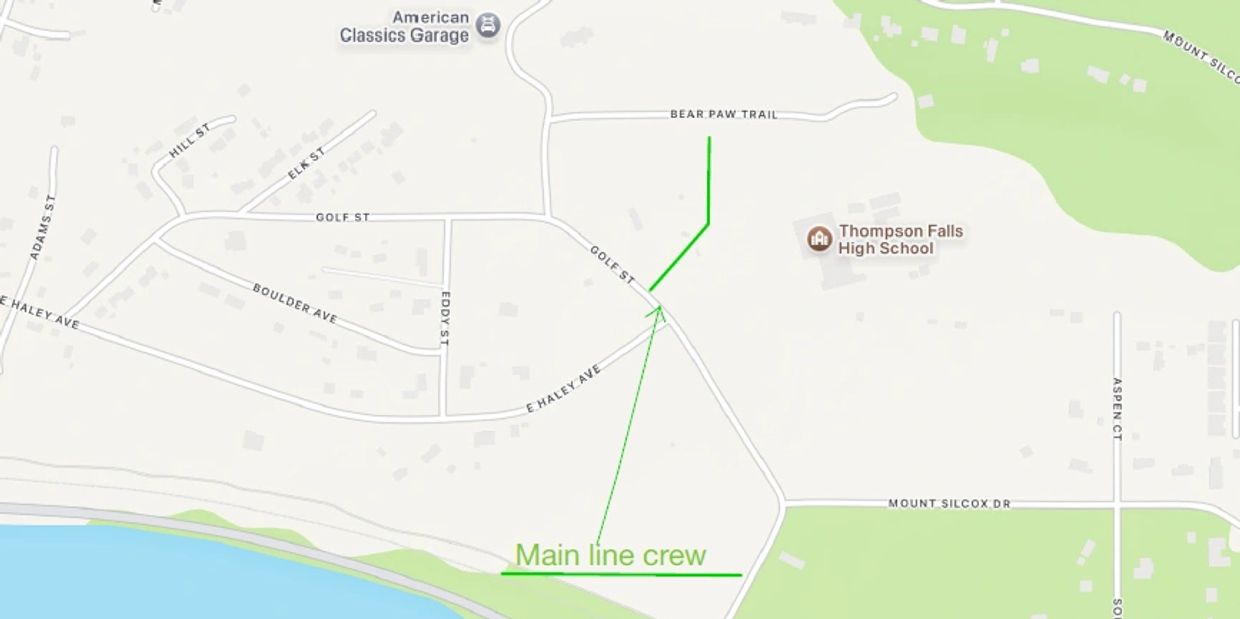

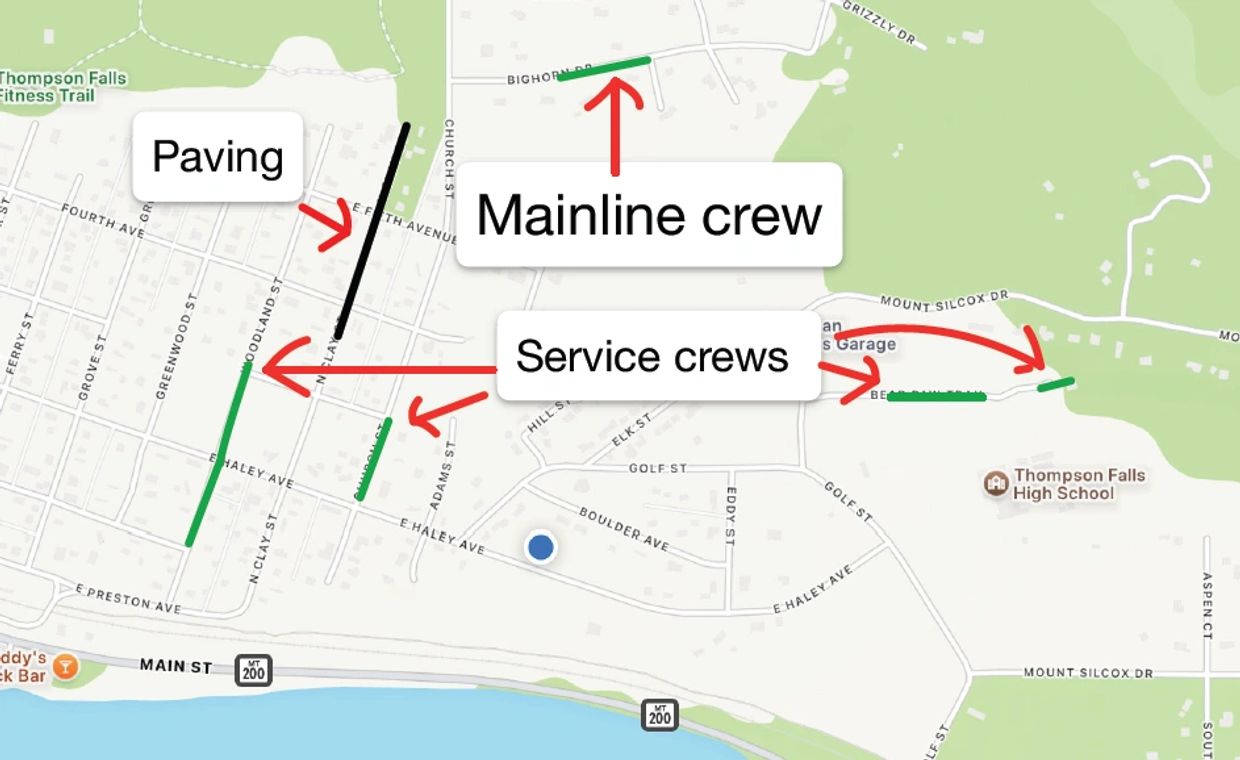

· The main line crew on Kaniksu should be done there in the next two weeks.

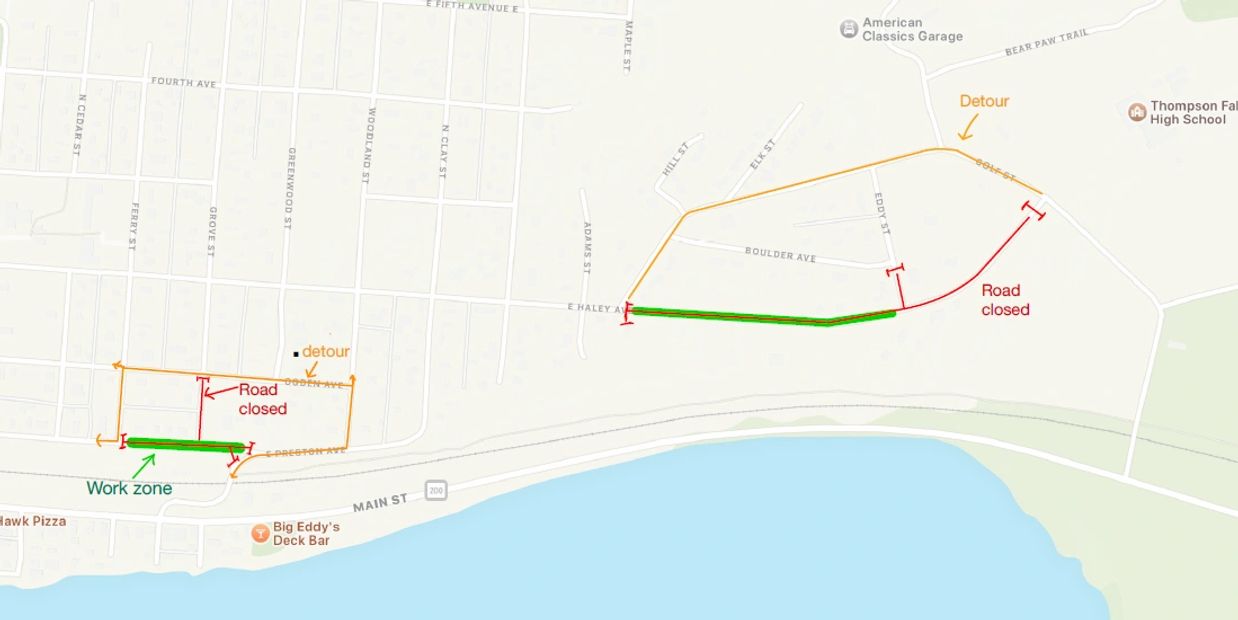

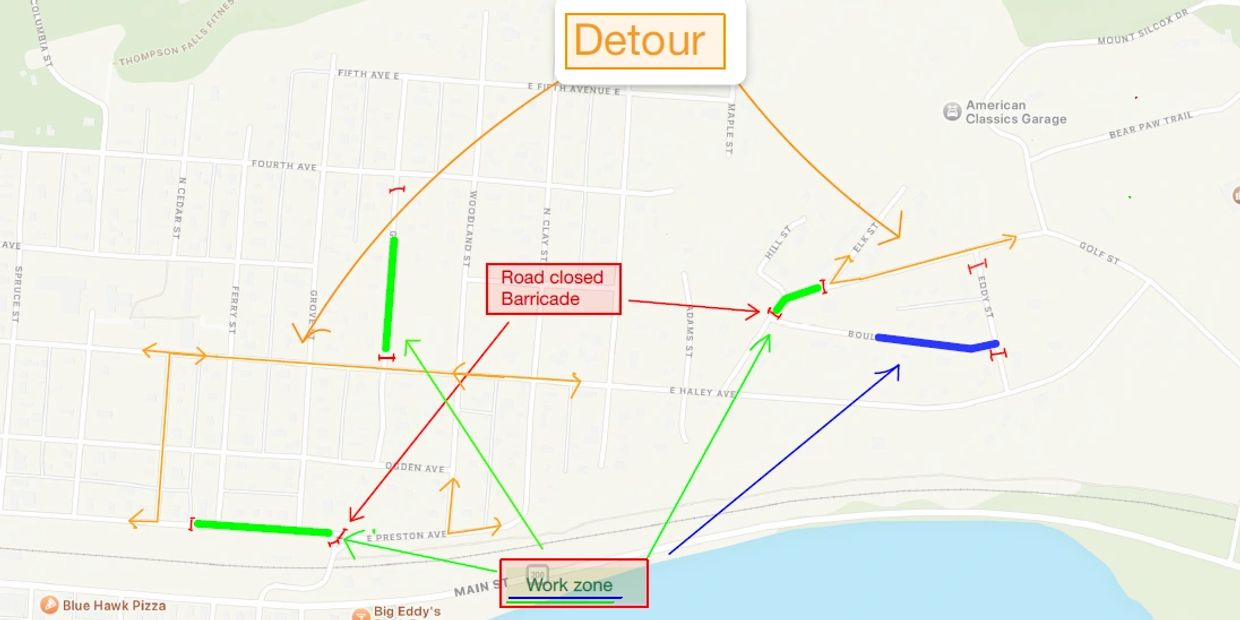

· The service crew on Clay St is done and is moving over to Church St.

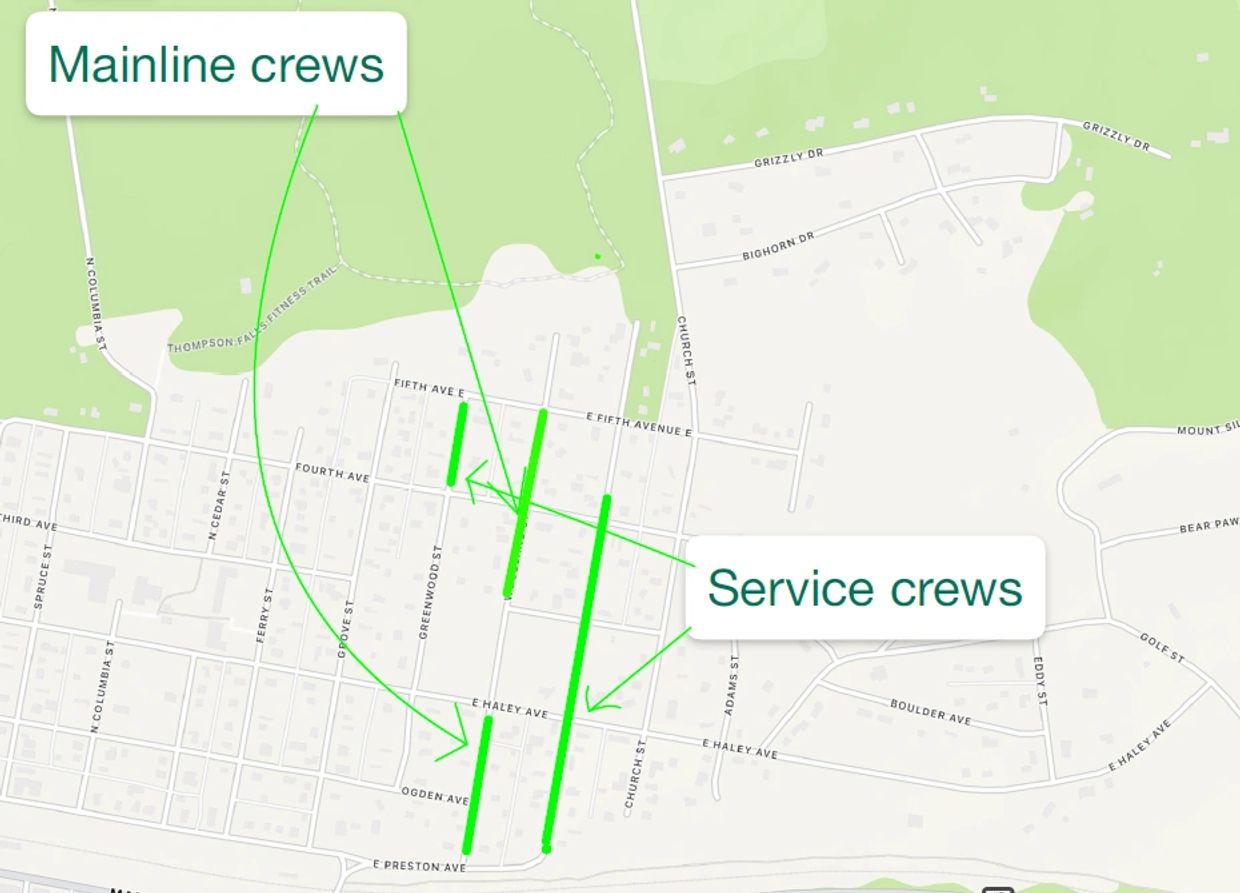

· The crew on Woodland will continue there for the next three weeks.
· The service crew on Woodland will continue there for the next three weeks.
· The crew on Bear Paw will be done next week.

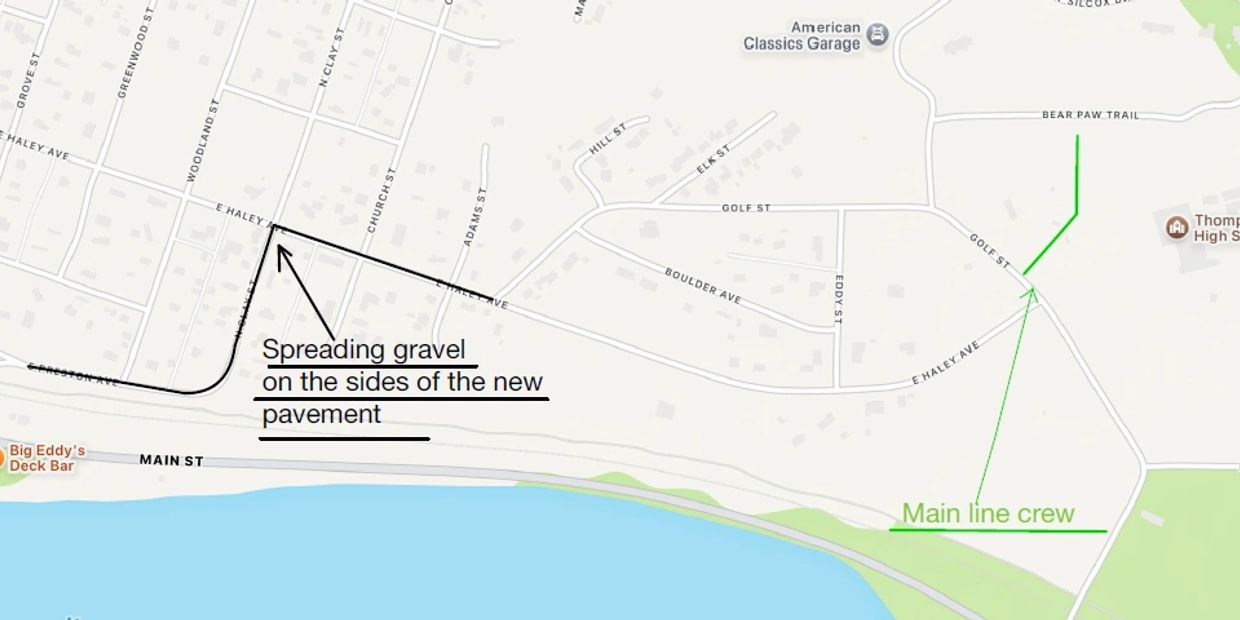

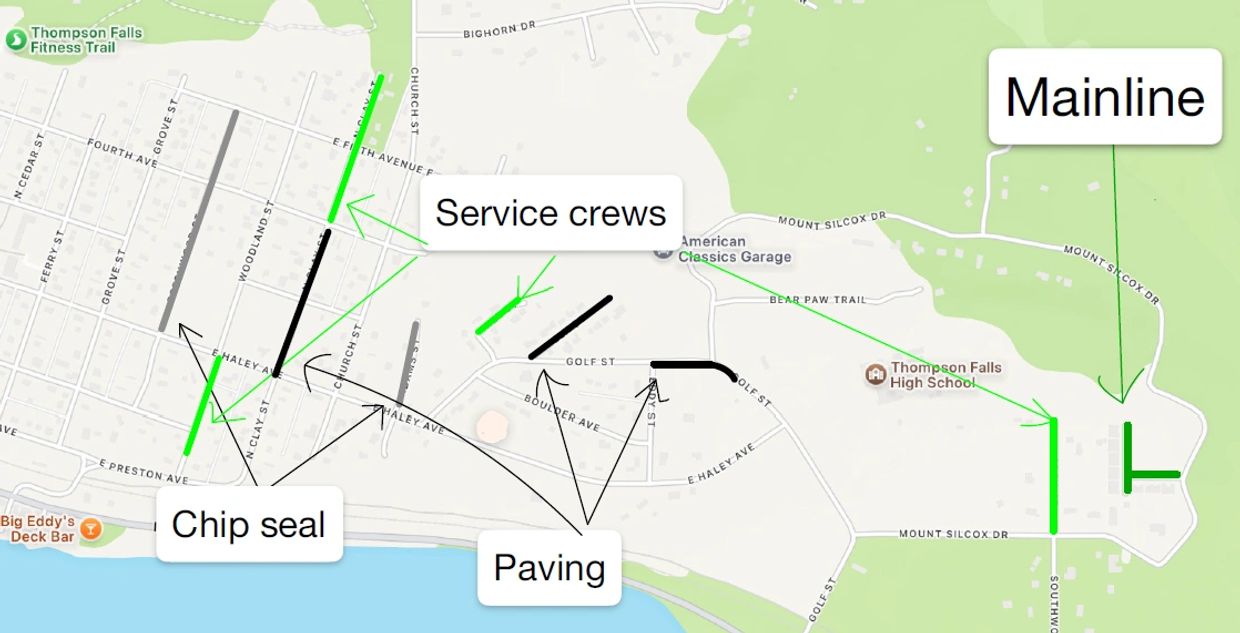

o Next, they will prep that street for paving.

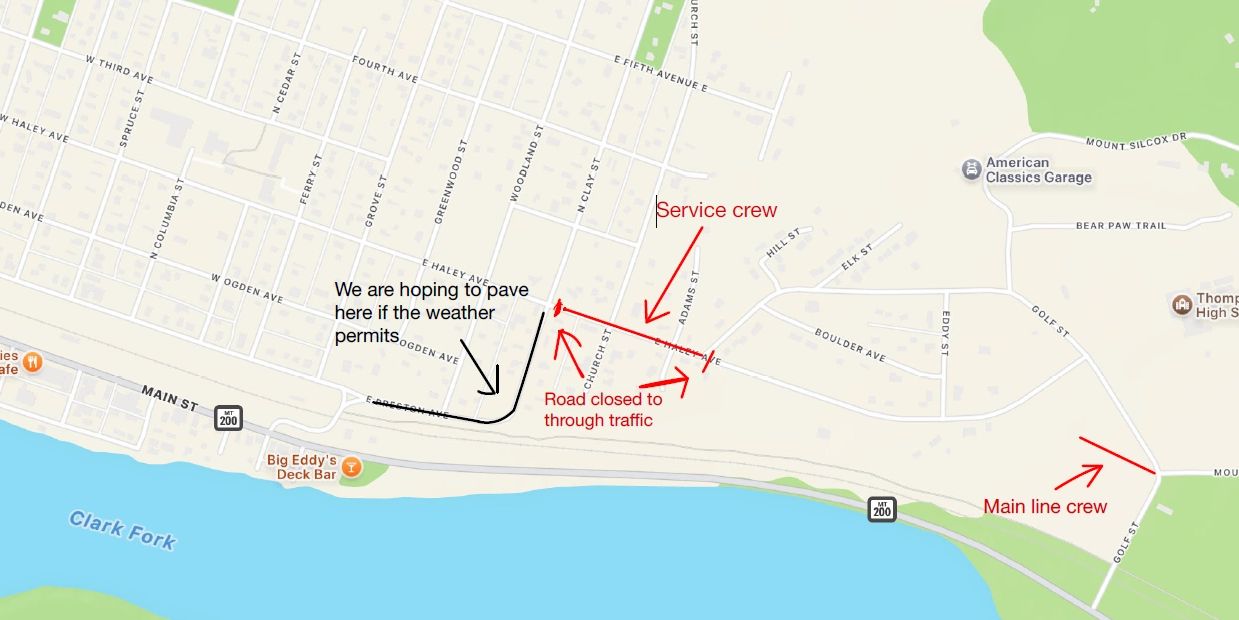

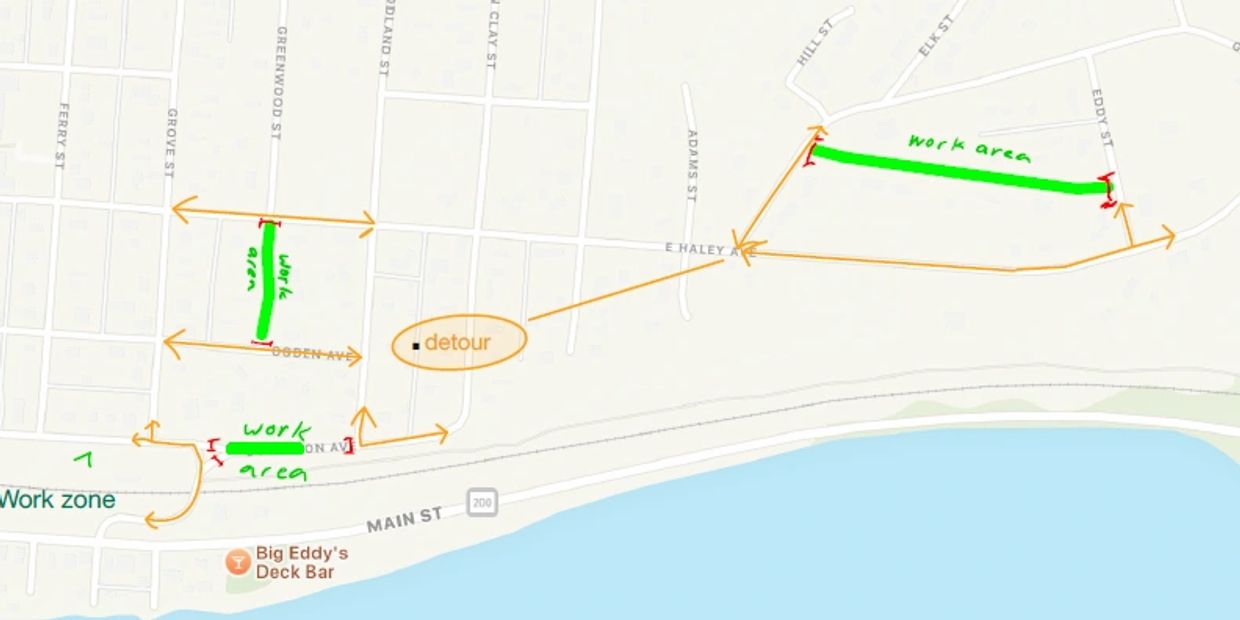

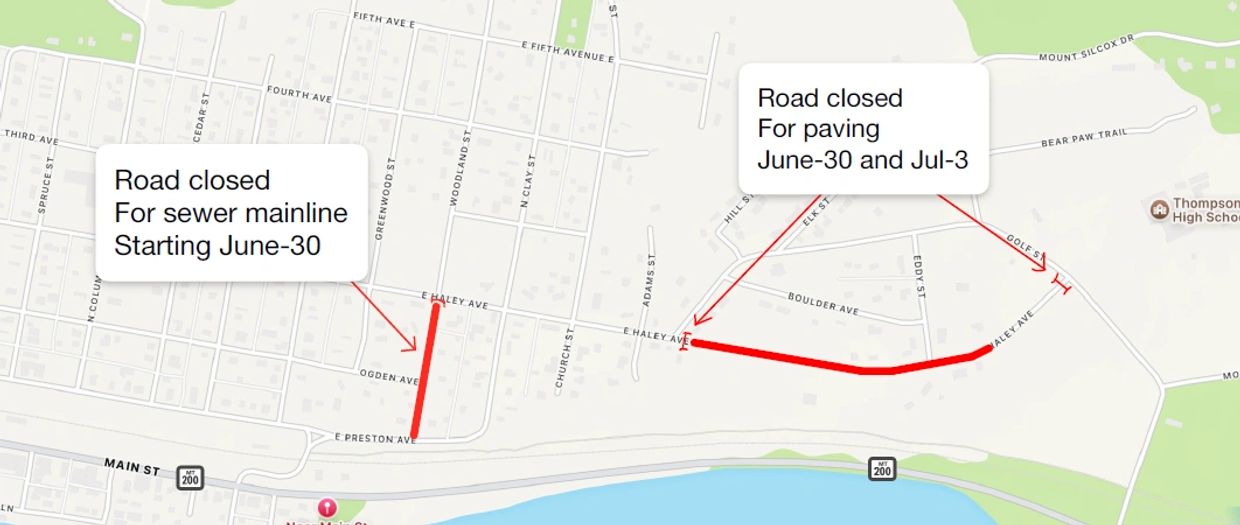

o In the next three weeks, we are hoping to pave Clay St, Church St from Haley to 4th and Bear Paw.
*Note: construction schedule is subject to change due to weather, unscheduled field conditions, etc. The weekly schedule is an estimated schedule.
Please be careful around these areas and follow all traffic control signs and directions. Please watch for equipment and truck traffic for your safety. If possible, please use alternate routes to avoid delays.
Construction will continue Monday- Thursday from 7:30 AM to 6:00 PM
